Tooling for Injection Moulding: Design, Cost, and Selection

Tooling for injection moulding is the engineered mold system that forms, cools, and ejects each plastic part. It normally includes the core and cavity, mold base, inserts, runner and gate system, cooling channels, vents, ejection, guidance, side actions, and any hot-runner or sensing hardware required by the project.

For a buyer, the key question is not simply which steel to use. The tool must match the resin, part geometry, annual and lifetime volume, critical dimensions, cosmetic requirements, molding machine, cycle-time target, validation level, and launch plan. Those inputs determine the appropriate tooling strategy, cavity count, material, expected service life, cost, and lead time.

tooling for injection moulding

This guide uses the British search term “tooling for injection moulding.” “Mould” and “moulding” are common in the UK and many Commonwealth markets; “mold” and “molding” are standard in the United States. The engineering meaning is the same.

Quick selection rule: use development or bridge tooling when design and demand are still changing; use production tooling when repeatability, maintenance, transferability, and sustained output are the priorities. In every case, define the tool by required performance and deliverables rather than by a supplier label alone.

Decision Primary question Why it matters
Tooling strategy How stable are design and demand? Sets the balance between speed, change flexibility, service life, and validation.
Tool material What resin, wear, corrosion, and finish are expected? Affects durability, polishing, repair, thermal behavior, and maintenance.
Cavity count What output is required at realistic uptime? Changes capital cost, balance, cooling, inspection, and production risk.
Runner system Is cold-runner waste acceptable? Changes material use, cycle behavior, thermal control, and maintenance.
Tool life What service conditions and maintenance plan apply? Defines wear strategy, replaceable inserts, spares, and long-term stability.
Lead time Which approvals and validation gates are required? Design freeze, component supply, machining, trials, corrections, and qualification drive the schedule.



Already have a 3D model? Send the CAD, material, annual volume, and target lead time through Kemal’s injection mold manufacturing service to request DFM feedback and a tooling quotation.

What Is Included in Injection Mould Tooling?

The word “tooling” may refer only to the mold, or it may include fixtures, gauges, hot-runner controls, spare inserts, handling equipment, and validation documentation. Buyers should define the boundary in the quotation.

Tooling element Main function Questions to confirm
Core and cavity Create the external and internal part geometry What are the critical dimensions, finish, texture, and wear areas?
Mold base and plates Support, align, and clamp the mold assembly Which machine, platen, tie-bar, mold-height, and mounting interfaces apply?
Inserts Localize complex geometry, wear areas, vents, or replaceable features Which inserts must be replaceable, interchangeable, or separately hardened?
Runner and gate Deliver melt to each cavity Cold or hot runner? Which gate type and location support filling and appearance?
Cooling system Remove heat and stabilize the cycle Where are the hot spots, circuits, connections, flow requirements, and cleaning points?
Venting Release displaced air and process gases Where can air trap, burn marks, diesel effect, or incomplete filling occur?
Ejection Release the molded part without damage Pins, sleeves, blades, stripper plate, air assist, or another method?
Side actions Form undercuts or side features Slide, lifter, collapsible core, unscrewing, or design change?
Guidance and support Maintain alignment and resist load Which guide, interlock, support-pillar, and wear-plate strategy is required?
Hot-runner hardware Control melt delivery without a conventional cold runner Manifold, tips, heaters, sensors, controller, spares, and approved brand?
Sensors and monitoring Confirm position, pressure, temperature, or cavity events Which signals are required for process control or traceability?

The tool specification should list what is included, what is optional, and what remains the buyer’s responsibility. This avoids disputes about controllers, spare components, sampling resin, inspection fixtures, or shipping hardware.

Start With DFM Before Tool Steel

The most economical time to correct a molding risk is before the tool design is released. A structured design-for-manufacturing review connects product intent to mold construction and process behavior.

A practical injection-moulding DFM review should address:

  • Material and shrinkage assumptions
  • Nominal and local wall thickness
  • Ribs, bosses, gussets, and thick intersections
  • Draft direction and draft angle
  • Parting line and shutoff geometry
  • Undercuts and side actions
  • Gate type, location, vestige, and trimming
  • Weld lines, air traps, flow length, and hesitation risk
  • Sink, void, warpage, and dimensional risk
  • Ejection, deformation, and cosmetic witness marks
  • Texture, polishing, color, gloss, and appearance zones
  • Critical-to-quality dimensions and datum strategy
  • Assembly, sealing, snap-fit, insert, and functional requirements

Kemal’s injection molding DFM guide provides additional design context. A formal project should also define who approves DFM, mold design, steel release, samples, dimensional reports, and engineering changes.

A useful DFM output

The DFM package should do more than label draft and wall thickness. It should show the proposed parting line, gate, ejector marks, slides or lifters, likely weld lines, cosmetic risks, shrinkage assumptions, and open decisions. Each decision needs an owner and approval status.

How to Choose the Right Injection Mould Tooling Strategy

“Prototype” and “production” are not universal mold specifications. Two suppliers may use the same label for very different steel, mold bases, cooling, documentation, and expected life. Define what the tool must achieve instead of buying a category name.

Tooling strategy Best fit Typical priorities Main trade-off
Prototype or development tool Design learning, functional testing, early market evaluation Speed, controlled changes, representative material and geometry Lower automation or service-life margin may be acceptable
Bridge or low-volume tool Demand exists but design or forecast is still developing Stable parts, manageable investment, repairable inserts May need replacement before long-term volume is reached
Production tool Stable design and sustained production Repeatability, cycle time, maintenance, interchangeability, documentation Higher engineering and validation commitment
Family tool Several related parts share one mold Consolidated tooling and molding Fill balance, cycle mismatch, scheduling, and scrap can be harder to control
Multi-cavity tool Higher output of the same part Productivity and consistent cavity performance More complex balancing, cooling, inspection, and maintenance

Read prototype vs. production tooling for a focused comparison. The correct decision depends on validated demand, change risk, resin, part complexity, quality requirements, available molding equipment, and the financial cost of downtime.

Procurement tip: ask each supplier to quote the same scope, expected tool life basis, cavity count, runner concept, validation deliverables, and transfer documentation. For a project-specific review, see Kemal’s mold manufacturing service.

Questions that prevent an underspecified tool

  1. What annual and lifetime quantity is expected?
  2. How stable is the product design?
  3. Is the tool intended for one supplier, one plant, or later transfer?
  4. Which molding machines must accept it?
  5. What cycle time is commercially necessary?
  6. Which dimensions and appearance zones are critical?
  7. What validation documents are required?
  8. Which spare and interchangeable components are needed?
  9. Who owns the tool and design data?
  10. What happens if volume, resin, or geography changes?

Core Tool-Design Decisions

Parting line and shutoffs

The parting line determines how the two mold halves meet. Its position affects flash visibility, machining, venting, ejection, side actions, and tool maintenance. Shutoff surfaces require enough strength and appropriate geometry to resist damage and repeated contact.

A visually hidden parting line may create unnecessary tool complexity. Choose it by function, appearance, manufacturability, and serviceability rather than appearance alone.

Gate and runner system

The gate controls where melt enters the cavity. Gate selection affects flow, shear, orientation, weld lines, pressure loss, gate vestige, automatic separation, and packing.

Cold runners are mechanically straightforward and can be appropriate when runner material, cycle, and trimming are acceptable. Hot runners reduce or eliminate cold-runner scrap and can support difficult filling or automation, but add thermal control, maintenance, start-up, and spare-parts requirements.

Use the project economics and material behavior to compare hot runner systems with cold runner injection molding. Do not select a hot runner only because the production volume sounds high; resin sensitivity, color changes, maintenance capability, gate cosmetics, and downtime risk also matter.

Cooling layout

Cooling often controls more of the cycle than injection. Uneven mold temperature can contribute to warpage, sink, dimensional drift, gloss variation, and long stabilization time.

The designer should consider channel location, diameter, distance from the cavity, circuit balance, pressure drop, flow direction, connectors, sealing, corrosion, cleaning, and access. Inserts, baffles, bubblers, high-conductivity materials, or conformal cooling may help in difficult areas, but each option adds manufacturing or maintenance considerations.

Venting

Air must leave the cavity as plastic enters. Vents are commonly placed at the parting line, around inserts, through ejector clearances, or at the end of fill. Inadequate venting can contribute to burns, short shots, poor weld lines, or excessive pressure. Excessive vent depth can create flash.

Vent dimensions are material- and process-dependent. They should be based on approved design standards and validated during sampling, not copied from an unrelated mold.

Ejection

Ejection must release the part without distortion, cracking, stress whitening, or unacceptable witness marks. The design may use pins, sleeves, blades, stripper plates, air, or combined methods.

Ejector location should consider draft, shrinkage onto cores, rib and boss geometry, surface appearance, part stiffness, and robotic handling. More ejectors do not automatically create a better system; force must be distributed where the part can tolerate it.

Slides, lifters, and unscrewing systems

Undercuts increase mold motion and risk. Slides and lifters require travel, locking, guidance, wear surfaces, lubrication, and position control. Threaded features may require unscrewing or a redesign.

Before adding a side action, compare the cost and reliability of the mechanism with a product design change, snap feature, separate component, post-machining operation, or alternate assembly method.

Injection Mould Tool Materials and Surface Requirements

Tool material should match wear, corrosion, polish, texture, dimensional stability, repair, availability, and expected service conditions. The tool base, cavity, core, inserts, slides, wear plates, and pins may use different materials.

Requirement Material-selection priority Questions for the supplier
General engineering resin Machinability, stability, wear, repairability What hardness and heat-treatment route are proposed?
Glass- or mineral-filled resin Abrasion resistance and replaceable wear areas Which gates, inserts, and flow paths receive extra protection?
Corrosive or flame-retardant resin Corrosion resistance and cleaning Which surfaces, cooling circuits, and components require protection?
High-gloss cosmetic surface Polishability, cleanliness, inclusion control What steel, polishing sequence, handling, and acceptance standard apply?
Heavy texture Texture response, draft, and repair Has texture depth been included in draft and dimensional planning?
High thermal load or hot spots Heat transfer and cooling strategy Are high-conductivity inserts justified and maintainable?

P20, 718-type steels, H13, stainless mold steels such as S136/420-type grades, and pre-hardened grades such as NAK80 are commonly discussed, but grade names and supply conditions vary by country and mill. The approved specification should define the standard, supplier, condition, hardness, heat treatment, and certification rather than relying on a trade name alone.

See Kemal’s guide to injection mold steel selection for a deeper comparison.

How Long Should Injection Mould Tooling Last?

Tool life is not a single number that can be chosen independently from resin, geometry, steel condition, moving mechanisms, cooling, molding conditions, and maintenance. A tool running an abrasive filled resin or complex side actions has a different wear profile from a simple unfilled-resin mold, even at similar production volumes.

For sourcing and quotation, define the expected annual and lifetime production, resin grade and filler, planned molding conditions, critical wear areas, repair strategy, spare components, and maintenance responsibility. The supplier should then state the material and hardness basis, replaceable-wear strategy, preventive-maintenance assumptions, and any conditions attached to a service-life commitment.

  • Resin abrasiveness, corrosiveness, additives, and processing temperature
  • Core/cavity material, heat treatment, hardness, coating, and surface requirement
  • Slides, lifters, shutoffs, gates, vents, ejectors, and other wear interfaces
  • Cooling-water quality, corrosion control, cleaning access, and storage conditions
  • Cycle conditions, setup discipline, preventive maintenance, and repair records

Treat “tool life” as a documented operating assumption, not a marketing label. A maintainable design with replaceable wear components and controlled records can be more valuable than a nominal shot-count claim with undefined conditions.

What Drives Injection Mould Tooling Cost?

Tool cost is the result of engineering, material, machining, purchased systems, assembly, sampling, inspection, change risk, and documentation. Part size is only one factor.

Cost driver Why it changes the tool Buyer decision
Part geometry Deep ribs, thin walls, undercuts, threads, and tight shutoffs increase work and risk Simplify geometry where it does not add product value
Cavity count More cavities add components, balancing, cooling, inspection, and maintenance Compare annual demand and required output with capital risk
Tool material Steel condition, heat treatment, corrosion resistance, and certification affect cost Match material to resin and intended life
Runner system Hot runners add manifold, heaters, controls, assembly, and service needs Compare material savings and automation with maintenance risk
Surface finish and texture High polish and controlled texture need appropriate steel and careful handling Define appearance zones and acceptance samples
Tolerances and CTQs Tight requirements need stronger datum control, processing, inspection, and iteration Tighten only dimensions that affect function
Side actions Slides, lifters, collapsible cores, or unscrewing add mechanisms and fitting Evaluate product redesign before accepting complexity
Cooling Complex circuits or conformal cooling add design and manufacturing work Justify with cycle, quality, and hot-spot data
Validation Sampling rounds, capability studies, gauges, and reports require time and resources Define documentation before quoting
Change risk Late revisions can rework steel, hot runners, electrodes, and documentation Freeze inputs through staged approvals

For a broader view of tool and part economics, see injection molding cost.

Compare total project cost, not only mold price

A lower mold quote can become more expensive if it creates long cycle time, excess runner scrap, frequent maintenance, unstable dimensions, difficult transfer, or repeated sampling. Compare the quotation boundary, assumptions, tool ownership, design rights, validation, spare parts, warranty, expected maintenance, and molding cost together.

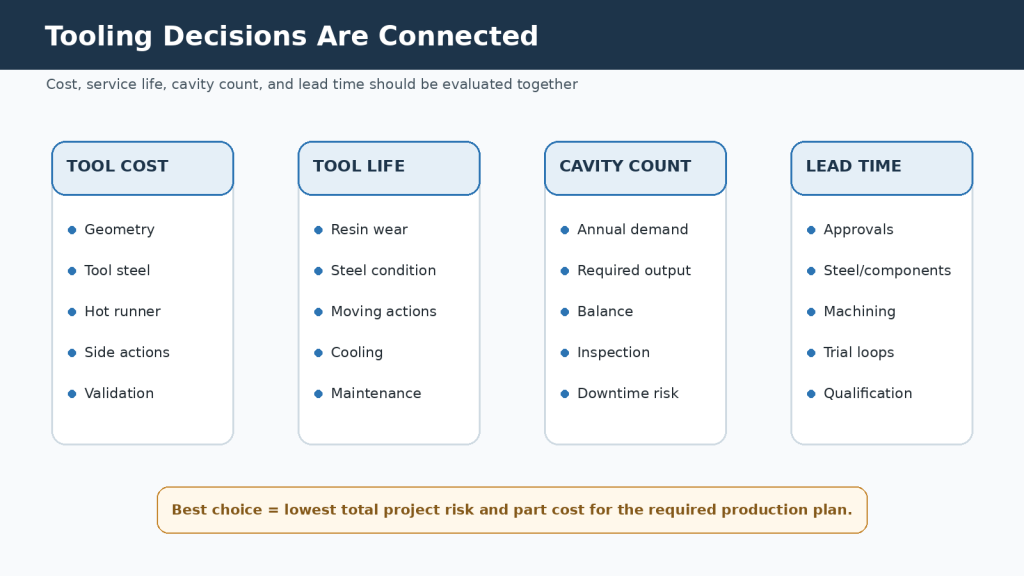

tooling decisions are connected

How Cavity Count Changes Tooling Cost and Output

More cavities can increase output per cycle, but they also increase the number of cavities, gates, cooling circuits, ejectors, inserts, and dimensions that must perform consistently. The right cavity count therefore depends on required output, cycle target, available press capacity, tool size, balance, inspection strategy, maintenance resources, and the commercial cost of downtime.

Before specifying a multi-cavity tool, compare the production plan for one, two, four, or more cavities using realistic uptime and scrap assumptions. A higher cavity count is most valuable when the molding process can keep all cavities balanced and qualified; otherwise it may concentrate too much production risk in one tool.

  • Required annual output and batch size
  • Target cycle time and available molding-machine capacity
  • Fill and pack balance between cavities
  • Cooling consistency and cavity-to-cavity dimensional variation
  • Inspection, traceability, spare inserts, and maintenance strategy
  • Downtime exposure if the entire production requirement depends on one tool

What Determines Injection Mould Tooling Lead Time?

Injection mould tooling lead time is a sequence of engineering and approval gates, not just machining time. The schedule starts with complete input data and DFM decisions, then moves through mold design approval, steel and purchased-component availability, machining, heat treatment where required, fitting, assembly, trial, correction, and qualification.

The fastest way to protect the launch date is to remove avoidable waiting between these gates. Confirm who approves DFM and mold design, which decisions must be frozen before steel release, what sample and inspection package is required, and how many correction loops are included in the commercial plan.

  • Part and drawing complexity, undercuts, textures, and tight shutoffs
  • Steel, hot-runner, sensor, and standard-component availability
  • Heat treatment, EDM, grinding, polishing, texture, and inspection requirements
  • Buyer response time for DFM, mold design, and sample approvals
  • Number and severity of issues found during tool trials
  • Qualification documents, capability studies, gauges, and transfer requirements

For a realistic schedule, request milestone dates for DFM approval, mold-design approval, steel release, first trial, correction, qualification, and production release rather than relying on one unsupported delivery date.

Ready for a tooling schedule and quote? Submit your 3D CAD, material, annual volume, target cavity count or output, and required launch date through Kemal’s plastic injection mold manufacturing page for DFM and tooling evaluation.

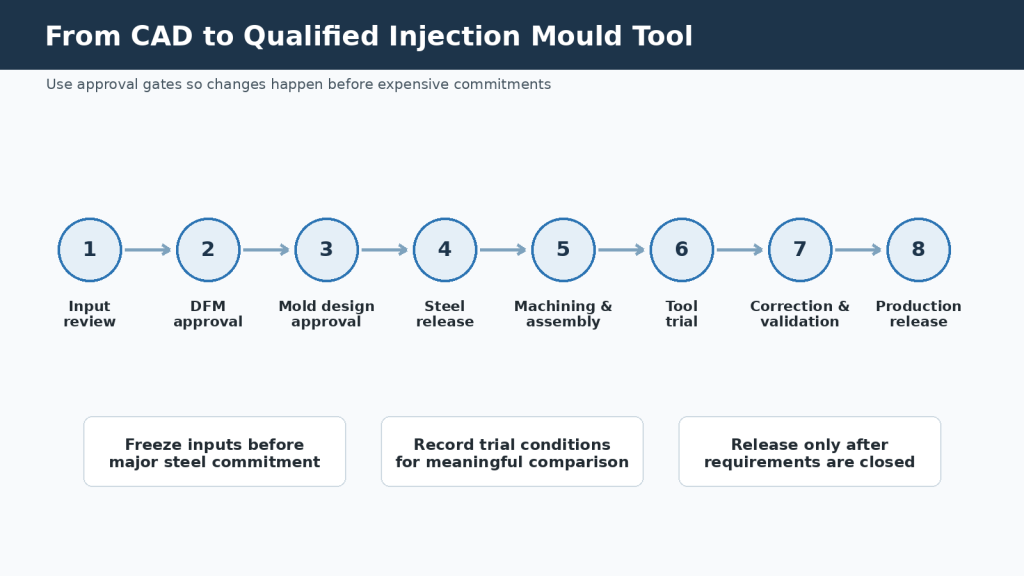

Injection Mould Tooling Process: From CAD to Qualified Tool

A controlled tooling project normally uses approval gates. Names vary by supplier, but the decisions should be explicit.

  1. Input review: Confirm CAD revision, drawing, resin, color, texture, quantity, machine, CTQs, standards, and required documents.
  2. DFM approval: Agree on parting line, gate, ejector marks, draft, side actions, shrinkage assumptions, cosmetic risks, and open issues.
  3. Mold-design approval: Review the mold layout, components, cooling, ejection, steel, hot runner, machine interfaces, and safety features.
  4. Steel release: Freeze the approved design and document any remaining risk before major material and machining commitments.
  5. Manufacturing and assembly: Machine, heat-treat, finish, inspect, fit, assemble, and function-check the tool.
  6. Initial sampling: Run the tool under recorded conditions and identify tool, process, material, or part-design issues.
  7. Correction and optimization: Close agreed actions using controlled design changes and repeatable sample conditions.
  8. Qualification: Approve dimensional, appearance, material, functional, and process evidence against the project plan.
  9. Transfer or production release: Deliver the approved tool, spares, drawings, records, setup information, and maintenance plan.

Kemal’s mold design services and mold manufacturing pages describe the relevant commercial paths. The exact approval and validation plan should be stated in the quotation and project schedule.

from cad to qualified injection mould tool

How to Evaluate First-Off-Tool Samples

A sample is meaningful only when its conditions are recorded. “The part looks good” is not a complete tool-acceptance decision.

Capture at least:

  • Tool and insert revision
  • Machine identification and key capacity data
  • Resin grade, lot, drying, color, and regrind condition
  • Mold-temperature and melt-temperature information
  • Fill, pack, cooling, and cycle settings
  • Cavity identification
  • Part-conditioning time before measurement
  • Dimensional, appearance, weight, and functional results
  • Deviations, temporary process concessions, and open actions

The tool, process, material, measurement method, and part design interact. If a dimension is outside specification, determine whether the cause belongs to steel condition, shrinkage assumption, gate/packing, cooling, measurement, conditioning, or the product drawing before changing the mold.

Kemal’s quality assurance page provides context for inspection capability. Project-specific acceptance must still be defined by the approved drawing and quality plan.

Common Tooling Problems and Corrective Direction

Symptom Tooling factors to inspect Other factors to rule out
Flash Parting line damage, shutoff fit, support, vent depth, alignment Clamp force, pressure, temperature, material viscosity
Short shot Gate/runner restriction, poor venting, cold area, flow imbalance Shot size, speed, temperature, material, machine response
Sink or void Thick geometry, gate freeze, insufficient local cooling Pack pressure/time, melt temperature, part design
Warpage Uneven cooling, ejection imbalance, gate orientation, steel condition Fiber orientation, processing, handling, part design
Burn marks Trapped air, inadequate venting, excessive local shear Injection speed, material degradation, contamination
Weld-line weakness Gate location, venting, flow split, local temperature Resin condition, process temperature, injection profile
Part sticking Insufficient draft, poor finish, undercut, ejection distribution Packing, cooling, release condition, material shrinkage
Gate blemish Gate type, size, location, vestige control Process, trimming, robot handling, cosmetic standard
Dimensional drift Cooling, wear, insert movement, unstable steel condition Resin lot, conditioning, process, measurement system

Do not begin by cutting steel. First confirm the defect, cavity, frequency, measurement system, material, process window, and recent changes. A reversible process trial or controlled measurement may prevent an unnecessary mold modification.

Tool Ownership, Documentation, and Transfer

Tool ownership should be explicit in the purchase agreement. The contract should define ownership of the physical tool, CAD, mold design, electrodes, hot-runner data, gauges, spare components, and process records.

For possible transfer, request a controlled documentation package that may include:

  • Final mold 3D and 2D data
  • Bill of materials and purchased-component details
  • Steel and heat-treatment records
  • Hot-runner and controller documentation
  • Cooling-circuit diagram
  • Tool drawings and change history
  • Trial records and approved process window
  • Dimensional and appearance reports
  • Spare-parts list
  • Maintenance and preservation instructions
  • Packing, lifting, storage, and shipment requirements

The receiving plant should review machine compatibility, utilities, connectors, safety, lifting, hot-runner control, and trial material before the tool ships.

How to Select an Injection Mould Tooling Supplier

A useful supplier review goes beyond a factory equipment list.

Evaluation area Evidence to request
DFM judgment A redacted review showing gate, parting line, draft, ejection, risk, and decision logic
Mold design control Approval workflow, drawing standard, revision control, and design checklist
Manufacturing capability Relevant machining, EDM, grinding, fitting, polishing, and inspection evidence
Sampling capability Machine compatibility, process recording, resin handling, and issue-closure method
Quality control Material records, dimensional reports, measurement capability, cavity traceability
Project management Milestones, owner, weekly status, open-issue tracking, and change control
Maintenance and support Spare strategy, repair response, documentation, and post-delivery support scope
Commercial clarity Tool ownership, quotation exclusions, change policy, validation, shipping, and warranty

Ask the supplier to explain one difficult decision and one prevented failure. Specific reasoning is more useful than a general claim of experience.

Need a Tooling Review Before You Commit to Steel?

For a meaningful tooling review, send the controlled 3D CAD and drawing, resin grade, annual and lifetime volume, critical dimensions, cosmetic requirements, required validation, production location, and target lead time. Open Kemal’s mold manufacturing service page and submit the project package to request DFM feedback and a tooling quotation.

Injection Mould Tooling RFQ Checklist: What to Send for a Quote

Include the following information in the RFQ:

  1. Controlled 3D CAD and 2D drawing revision
  2. Resin manufacturer and grade, filler, color, and additives
  3. Annual volume, lifetime volume, batch size, and forecast confidence
  4. Prototype, bridge, or production intent
  5. Preferred cavity count or required output
  6. Critical dimensions, tolerances, datums, and measurement methods
  7. Cosmetic zones, texture, polish, color, and defect standard
  8. Functional, assembly, sealing, regulatory, and traceability requirements
  9. Molding-machine and plant interface requirements
  10. Runner preference and material-reuse restrictions
  11. Insert molding, overmolding, automation, or secondary operations
  12. Sample quantities and validation documents
  13. Tool ownership, destination, transfer, spares, and documentation
  14. Required milestones and commercial launch date

If these inputs are not ready, ask for a phased quotation that separates DFM, tool concept, tooling, sampling, validation, molding, secondary operations, and shipping. This makes assumptions visible before they become change orders.

Maintenance Begins During Tool Design

Maintainability is a design requirement. The tool should provide safe access, replaceable wear components, identifiable circuits, documented spares, and realistic cleaning methods.

Useful planning includes:

  • Replaceable gate, vent, shutoff, and wear inserts where justified
  • Standard purchased components where practical
  • Accessible cooling circuits and cleaning connections
  • Identification of cavities, inserts, circuits, and sensors
  • Approved lubrication and cleaning materials
  • Inspection intervals based on resin and operating conditions
  • Controlled storage, corrosion protection, and restart checks
  • A record of shots, maintenance, repairs, and dimensional trends

The maintenance interval cannot be set by shot count alone. Abrasive or corrosive materials, high temperature, complex actions, water quality, environment, and process stability all affect service needs.

Frequently Asked Questions

What is tooling for injection moulding?

It is the mold system used to form, cool, and eject an injection-molded part. It normally includes the mold base, core, cavity, inserts, runner and gates, cooling, vents, ejectors, guidance, side actions, and any hot-runner or sensor hardware.

What is the difference between a mold and tooling?

The terms are often used interchangeably. In a project contract, “tooling” may include the mold plus hot-runner controls, gauges, fixtures, spare inserts, documentation, and validation work. Define the quotation boundary explicitly.

Should I choose prototype or production tooling?

Choose by design stability, volume, resin, part complexity, validation, service life, cycle, automation, and the cost of downtime. Do not rely only on a supplier’s “prototype” or “production” label; specify the required output and deliverables.

Is aluminum or steel better for injection mould tooling?

Neither is universally better. Aluminum may support certain development or lower-volume applications, while steel provides a wider range of wear, polish, corrosion, and long-term production options. Geometry, resin, volume, finish, maintenance, and supplier capability determine suitability.

What makes injection mould tooling expensive?

Major drivers include part complexity, cavity count, tool material, side actions, hot runners, cooling, finish, tolerances, inspection, validation, documentation, and design-change risk. The cheapest mold price may not produce the lowest total part cost.

How long does injection mould tooling take?

Lead time depends on tool size, complexity, steel and component availability, design approvals, machining, heat treatment, fitting, sampling, corrections, and validation. Request a milestone schedule rather than one unsupported delivery date.

What files are needed for a tooling quote?

Provide controlled CAD and drawings, resin grade, volume, critical dimensions, cosmetic and functional requirements, validation needs, machine or plant constraints, tool destination, and required launch date.

When is a tool ready for production?

A tool is ready when approved samples meet the agreed dimensional, appearance, functional, material, and process requirements under recorded conditions; open issues are closed; documentation and spares are complete; and the production team accepts the process window and maintenance plan.

Final Takeaway

Successful tooling for injection moulding begins with a controlled product definition and ends with a repeatable, maintainable production system. Buyers should approve DFM, tool design, steel release, samples, corrections, validation, documentation, and transfer through clear project gates.

The best tooling decision is not automatically the hardest steel, highest cavity count, shortest quoted lead time, or lowest initial price. It is the tool architecture that fits the resin, geometry, demand, quality risk, molding equipment, service plan, and commercial objective.

If you are comparing tooling options now, send your 3D CAD, drawing, resin or material specification, annual volume, critical tolerances, validation requirements, and target lead time. Visit Kemal’s injection mold manufacturing service to request a DFM review and tooling quotation, with the mold design, manufacturing, trial, and later injection-molding requirements evaluated as one project path.

Rate this post
Put your parts into production today

Content in this article

Upload your files to get an instant quote and DFM feedback.

For your 3D model, we accept these file formats: STL (.stl), STEP (.stp), IGES (.igs), or Compressed folders (.ZIP). The maximum supported file size is 10MB. For large or multiple files please place into one folder and compress into a ZIP or RAR file.

*We respect your confidentiality and all information are protected.

If your submission fails, please email km@kemalmfg.com.

Learn How to Manufacture Better Parts
